GATE 2025 CE (CE2) – Question 53

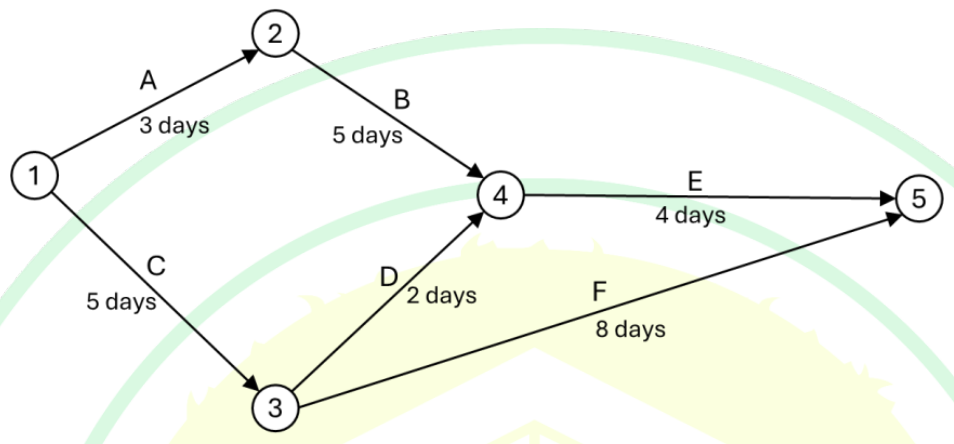

The figure shows a network diagram for a construction project. The activities A, B, C, D, E, and F are represented by arrows and their durations are in the figure.
The total float available for the activity E in day(s) is equal to _____ (round off to the nearest integer).

Practise this question in The GATE Grind →
Show answer and explanation
Correct answer: 1
Explanation
The paths from event 1 to event 5 are A-B-E = 3 + 5 + 4 = 12 days, C-D-E = 5 + 2 + 4 = 11 days and C-F = 5 + 8 = 13 days. The critical path is C-F, so the project duration is 13 days. The earliest finish of E is $\max(3 + 5, 5 + 2) + 4 = 12$ days, and the latest finish of E is 13 days. The total float of E is $13 - 12 = 1$ day.
More Project planning and scheduling: AOA and AON, PERT and CPM questions
- GATE 2024 CE (CE2) Q38
- GATE 2024 CE (CE2) Q52
- GATE 2022 CE (CE1) Q39
- GATE 2022 CE (CE2) Q53
- GATE 2021 CE (CE1) Q53
- GATE 2021 CE (CE2) Q52
All Project planning and scheduling: AOA and AON, PERT and CPM questions →
