Mineral Economics, Mine Planning, Systems Engineering · Systems Engineering · 1 mark · Numerical answer

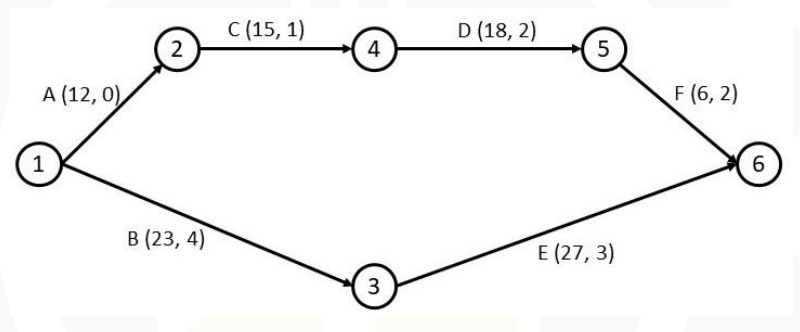

Activities in the project network are labelled(expected days,standard deviation in days). Find the standard deviation of project completion time to one decimal.
Path A–C–D–F takes12+15+18+6=51 days; B–E takes23+27=50 days. The first path is the expected-time critical path. Under the usual independent-activity PERT approximation its variance is0²+1²+2²+2²=9 days², so standard deviation3.0 days. This approximation follows the critical path, not the sum of every activity variance.
More Systems Engineering questions
GATE 2026 MN Q42– Dumpers arrive exponentially at5/hour and loading times are exponential. Waiting cost…
GATE 2026 MN Q47– Assign four jobs J1–J4 to engineers S1–S4, one job each. Costs by row are…
GATE 2025 MN Q37– Transportation costs to Mines1,2,3 are supplier S:(10,15,50),O:(5,2,100),I:(30,40,20)…
GATE 2024 MN Q19– An M/M/1 shovel queue has arrival rate 9 dumpers/hour and service rate 12/hour. Find…
GATE 2024 MN Q20– The project network is shown. Activities A, B, C, D, E have durations 5, 6, 8, 3, 4 weeks…
GATE 2024 MN Q36– Faces 1 and 2 can produce at most 1600 and 2000 tonnes/day, at Fe 63% and 58% and…
